Skip to main content

JSJ Construction

Tata Steel Crane Foundation

Share On

what we Did

CLIENT

Tata Steel

LOCATION

Corby, Northamptonshire

SECTOR

Specialist Civil Enginnering

COMPLETION

2025

JSJ Construction was appointed by Tata Steel UK Limited to deliver the civil engineering works for a new 10-tonne overhead crane foundation inside an existing manufacturing facility in Corby.

The site presented a demanding mix of structural, access and programme constraints. The foundation had to be built in a tightly confined area surrounded by operational machinery and structural steelwork, with restricted headroom and all access through a single roller-shutter doorway. Every stage of the work, from breakout to final concrete, had to be completed within the client’s two-week summer shutdown.

SCOPE OF WORKS

BREAK OUT AND EXCAVATION

  • Break out existing reinforced concrete floor within the foundation footprint
  • Excavate to 1.2m below floor level
  • Create working clearance for the piling rig inside the building
  • Remove all arisings through the single roller-shutter access

MINI-PILING

  • Mini piling rig selected for restricted headroom
  • Four in-situ reinforced concrete piles
  • Approximately 12 to 15m depth to natural ground and bedrock
  • Piles positioned to suit the crane column loading

TESTING AND VERIFICATION

  • Integrity testing on all four piles before pile-cap construction
  • Concrete cube testing to confirm early strength
  • Verification completed within the shutdown programme
  • Sign-off before committing to the next stage

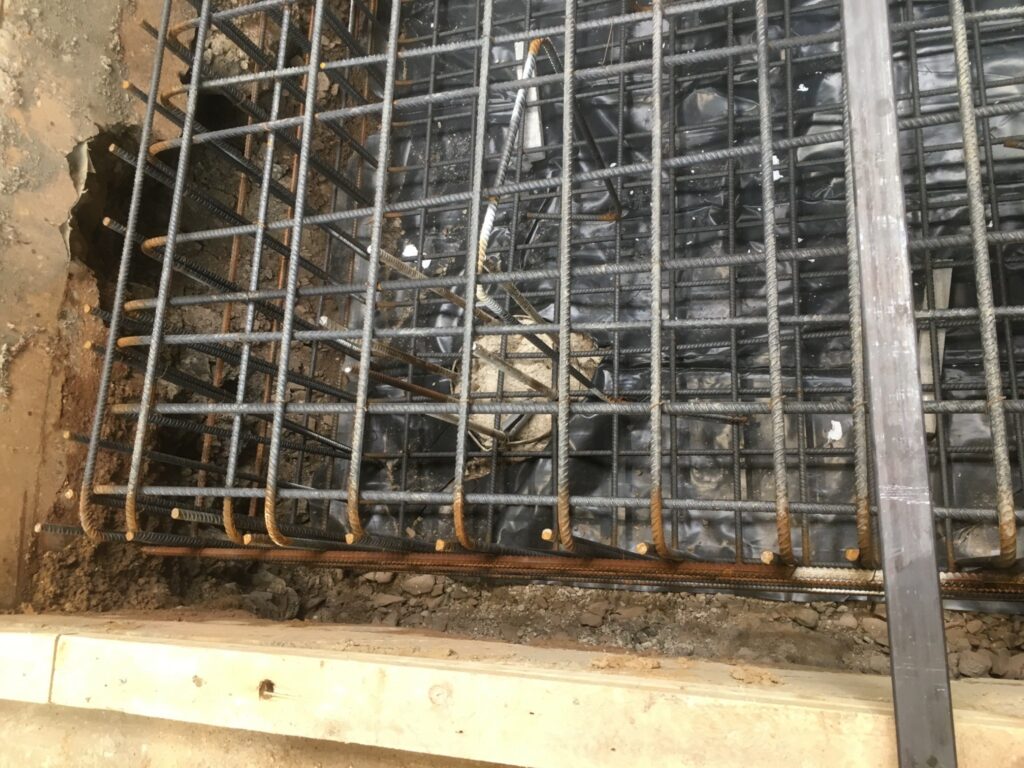

REINFORCED PILE-CAP

  • Heavily reinforced pile-cap assembled within the excavation

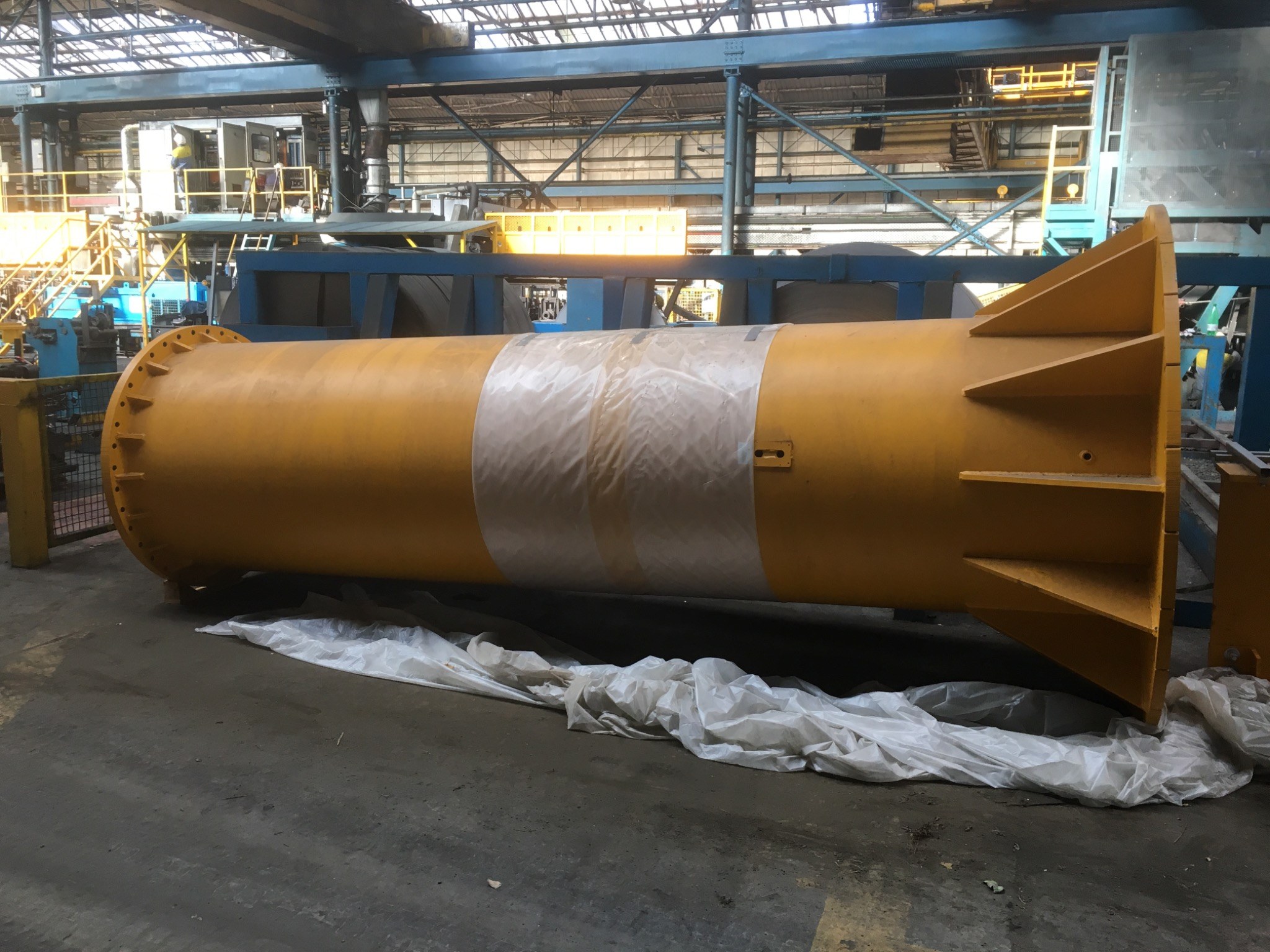

  • Pile connections and crane-base interface steelwork incorporated
  • Approximately 60m³ of specialist fast-track concrete
  • Required early strength achieved within three days

THE CHALLENGE

This was a deep-piled structural foundation constructed inside a working factory, not a routine slab. All plant, materials, personnel and excavated arisings had to pass through one roller-shutter doorway, and the working area was enclosed by fixed equipment that left no room for conventional plant.

Sequencing was everything. Plant selection, deliveries, temporary segregation, excavation, piling, reinforcement and concrete placement all had to be coordinated around the physical limits of the building and a fixed shutdown window that could not move.

THE RESULT

The complete foundation was handed over within the two-week shutdown. A specialist fast-track concrete achieved the required early strength within three days, removing the conventional curing period from the critical path and allowing the crane installation to follow immediately.

The new 10-tonne crane is now in operation, and the facility returned to production on schedule. The project demonstrates JSJ’s ability to plan and deliver technically demanding works where access, space, live operations and programme are all critical.

SITE GALLERY
